Project Description
The Ackerman MSBU was approved in November 2019. This project includes construction of a wastewater collection system to service approximately 1,300 properties with sewer service, new water service lines and a vacuum station that will provide sewer collection for the wastewater system.
- The vacuum station is expected to be complete by spring 2023. Connections are expected to start late spring 2023.
- Installation Agreements for zones 1 and 2 have been mailed out. Please be sure to sign and return them to the Utilities Department as soon as possible.
- Construction has started on the water line replacement and sewer main installation throughout the project. The vacuum station is currently under construction.
- The BCC approved the contract for the Vacuum Station and zones 1 and 2. Contractor: Guymann Construction of Florida, Inc.
Capital Projects Office
Phone: 941.764.4305
Email: S2S@CharlotteCountyFL.gov
Project Location
Throughout the Ackerman Avenue neighborhood.
Construction materials are being stored at the corner of Ohara Drive and Midway Boulevard.

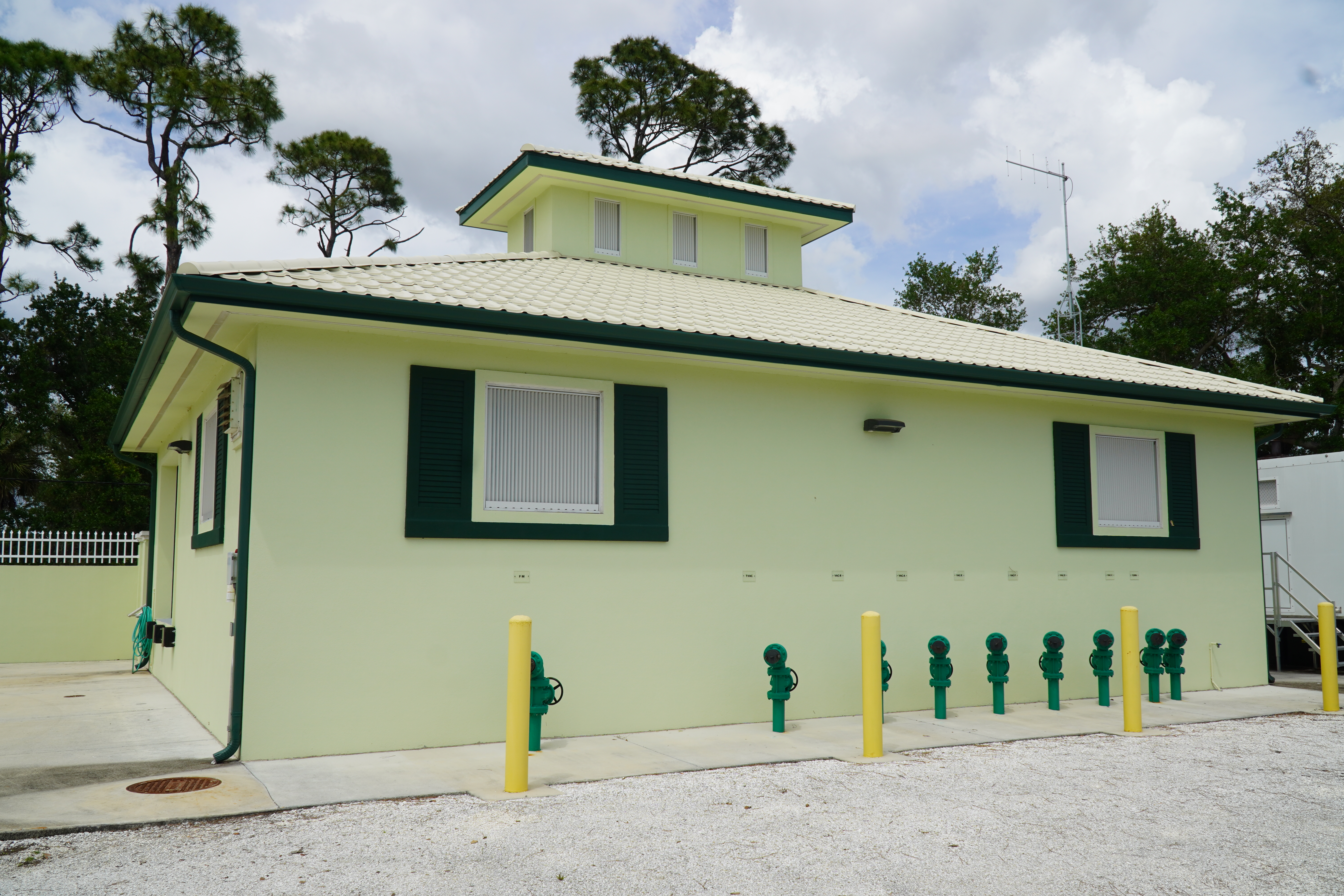

The vacuum station located at, 18330 Ackerman Avenue is currently under construction in addition to the vacuum collection system.
Project Impacts
Residents in the Ackerman project area may experience low water pressure for the next few months. Crews are currently transferring over to the water new lines and flushing to keep chlorine residuals up in the area. Work also includes connecting customers to the newly installed lines.
Crews are encountering large amounts of rock during excavation, which has resulted in an unplanned rock crushing operation at the construction yard.
Latest Updates
Installation Agreements for zone 1 and 2 have been mailed out. Please be sure to sign and return them to the Utilities Department as soon as possible. These forms give CCU permission to come on your lot with a plumber to connect your home to the central sewer line currently being installed. This work is included in your MSBU assessment, and there are no additional costs. For questions, contact: Syndi Merriman at 941-764-4305 or S2S@CharlotteCountyFL.gov
Crews have completed the water main replacement in zones 1 and 2 of the project area. Zones 1 and 2 connections are expected to start in late spring 2023.
Budget
Phase | Cost |
---|---|
Total Budget | $26,948,870.00 |
Resident Assessments, Florida Department of Environmental Protection State Revolving Funds, EPA Grants, RESTORE, Utility Repair and Replacement Funds.
Schedule
Phase | Estimated Start Date | Forecast Completion | Actual Completion |
---|---|---|---|
Planning and Approval | 11/19/2019 | 12/01/2020 | |
Design Development | 01/21/2021 | ||
Construction | 04/05/2021 | 02/23/2023 |
Supporting Materials
Project Phase
Construction
Last Updated
01/24/2023
Project Manager
Mike Martindell
Public Relations
Caroline Wannall
Email Public Relations
Sponsor Department
Utilities
Design Engineer/Architect
Giffels-Webster Engineers
Construction Contractor
Guymann Construction of Florida, Inc.
