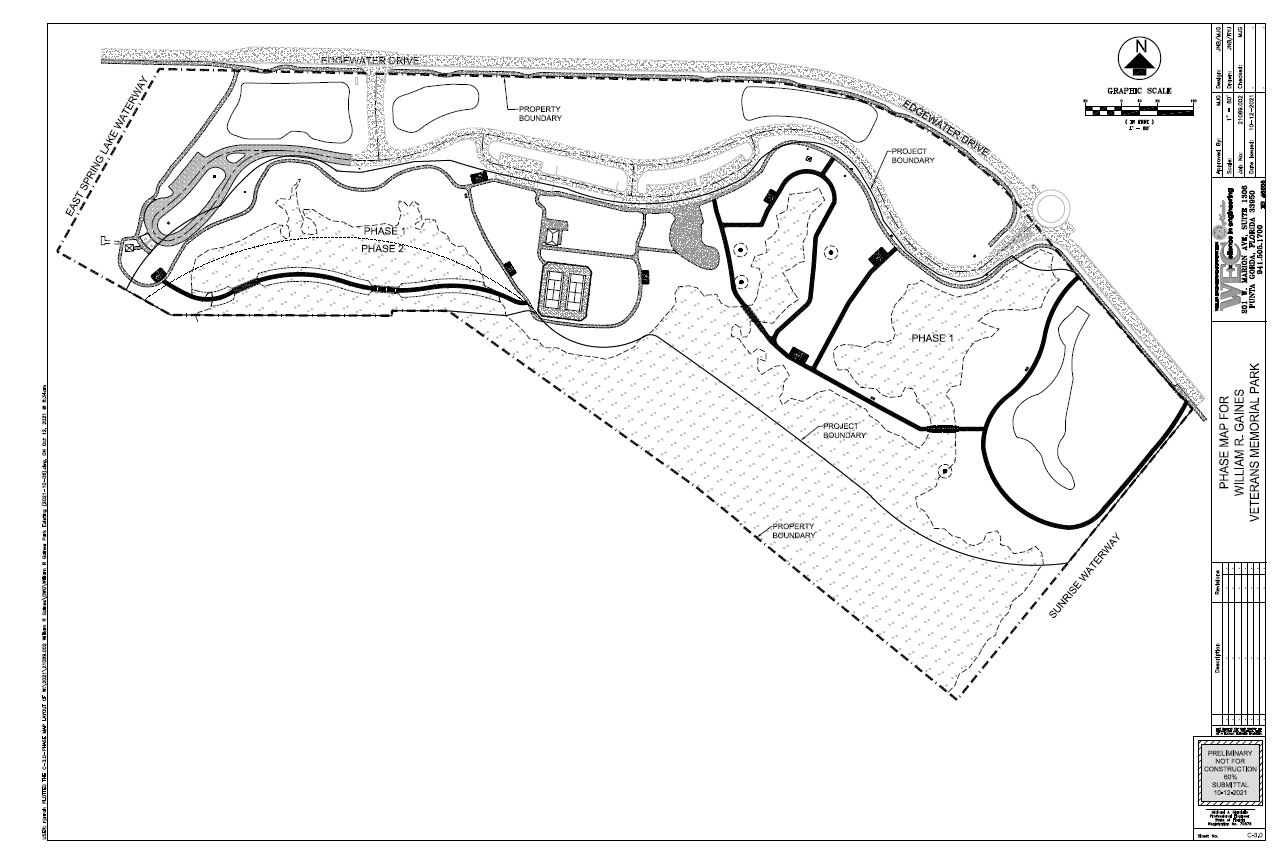

Project Description

Design and construction of upland and wetland trails throughout William R. Gaines Jr. Veterans Memorial park. Elements of the project include nature trails, elevated boardwalks, education signage and kiosks and fitness equipment.

Project Location

William R. Gaines Jr. Veterans Memorial Park

20499 Edgewater Dr.

Port Charlotte, FL 33952

Project Impacts

Wetland impacts have been identified for the project. Wetland mitigation credits need to be purchased and are listed under other in the project budget breakdown.

Latest Updates

Finalizing 60% design plans and identifying wetland impacts

Wetland impacts have been identified and design is ready for approval. Permitting applications have been submitted to Southwest Florida Water Management District and U.S. Army Core of Engineers permitting will be required as well. The total permitting process is expected to take aproximately 18 months.

Permits were submitted to the various permitting agencies on 11/23/2021 and could take up to 18 months to gain approval. Adjustments will be made to the plans as we receive comments back from the permitting agencies.

Onsite meeting with SWFWMD scheduled for 3/11/22.

Comments and responses trasnmitted with Army Core of Engineers. Project is still in permitting phase with ACOE.

90% plans are in progress

Approval to begin the tree survey has been authorized.

Tree survey is complete and the project is awaiting approval from ACOE

ACOE approval received in May, clearing of access has begun for contractor. Documents in preparation for bid process

Bid documents were completed and sent to Purcahsing in July.

Project is out to bid and sealed bids are due back September 20, 2023.

Bids were received back and are scheduled to go to the Board of County Commissioners for vendor award approval in November 2023.

Construction awarded and waiting on NOC from granting agency. Construction is anticipated to start January 2024.

NOC from granting agency was received and surveying on the site will begin January 22, 2024.

Construction on the site began on 1/29/24.

Budget

Phase Cost
Design $85,700.00
Construction $763,810.46
Other Costs $175,299.00
Total Budget $1,024,809.40
Funding source(s): Funding comes from the following sources: Capital Projects Fund, 2014 Sales Tax Fund and Recreation Trails Program through Florida DEP

Schedule

Phase Estimated Start Date Forecast Completion Actual Completion
Design Development 10/09/2020 09/09/2021

Supporting Materials

Project Phase
Planning and Project Approval

Last Updated
03/01/2024

Project Manager
Lacey Solomon

Public Relations
Lacey Solomon
Email Public Relations

Project Number
c721801

Sponsor Department
Community Services

Design Engineer/Architect
Weiler Engineering Corporation

Sales Tax Project

Delivering Exceptional Service

Questions? Issues?

Contact Us
